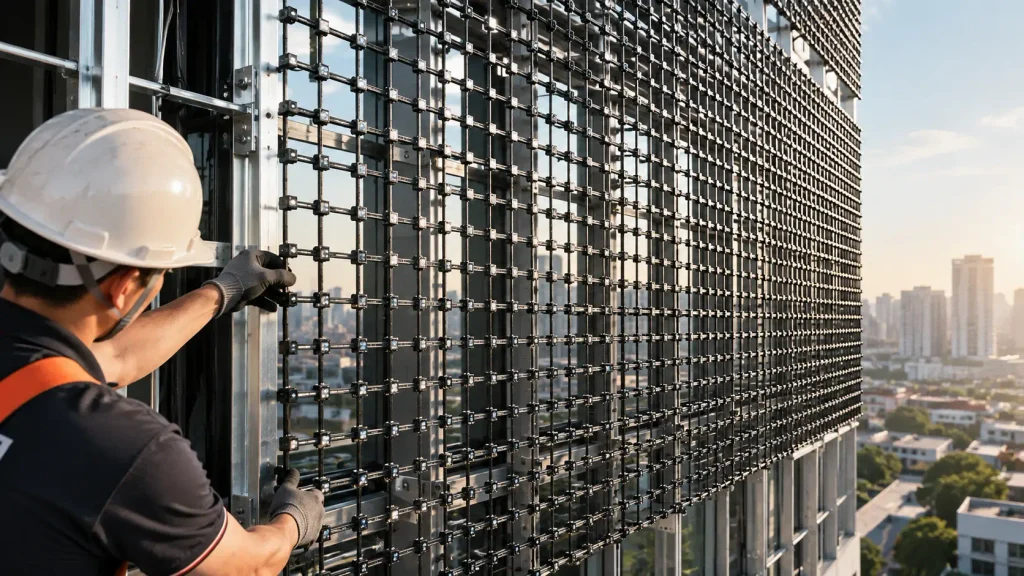

LED mesh screen installed on a building facade

Media Facade Installation: Structure, Power Distribution, Signal Control and Testing

By the MEKALEO engineering team — 22 years of LED facade production since 2004

Core Summary

A media facade installation succeeds when four systems are engineered together before any LED unit is lifted: the support structure (dead load and wind load), the low-voltage power distribution (voltage drop, protection and lightning/surge coordination), the signal and control network (DMX/RDM or receiving-card topology), and a staged test and handover plan.

The sequence for contractors is: review drawings → site survey → structural check → frame installation → unit mounting → power → signal → waterproofing → staged commissioning → acceptance and handover records.

13 stepsFrom drawing review to maintenance plan
ΔV = I × RVoltage drop checked at maximum temperature
32 unit loadsPer DMX segment before a repeater or splitter
120 ΩTermination at the end of each DMX line

Safety note

Structural calculations, electrical connections, grounding, lifting operations and work at height must be completed by qualified professionals. Always follow the manufacturer’s installation manual and the building, electrical, fire and occupational safety regulations of the project location.

1. The Media Facade Installation Workflow

A media facade installation for an LED mesh screen, LED pixel-point matrix or linear media system follows one engineering workflow in four phases: planning, mechanical installation, electrical and signal installation, and commissioning and handover. Each phase has a hold point; the next phase starts only after the previous phase passes inspection.

Media facade installation workflow in four phasesFour phases with hold points: Planning (drawings, survey, structural and electrical design), Mechanical (frame, alignment, LED units), Electrical and signal (power, grounding, surge protection, data, waterproofing), Commissioning and handover (pre-power checks, staged energizing, DMX/RDM addressing, burn-in, acceptance records).PHASE 1PlanningDrawings & manualSite surveyStructure & windPower & signal designPHASE 2MechanicalMark reference linesInstall support frameLevel, plumb, torqueMount numbered unitsPHASE 3Electrical & signalPower distributionBonding & SPDsData topologyWaterproofingPHASE 4Commission & hand overPre-power testsBranch-by-branch powerRDM addressingBurn-in & recordsHOLDHOLDHOLD
Figure 1. Four-phase media facade installation workflow. Each hold point is an inspection gate: structure before units, electrical tests before power-on, and full-system testing before handover.

An installation video showing site inspection, frame installation, unit mounting, power and signal connections, grounding, waterproofing, control configuration and final inspection is available: How to Install an LED Mesh Screen on a Building Facade. Product specifications for the screens used in this guide are on the MEKALEO LED mesh screen page.

2. Review the Drawings and Conduct a Site Survey

2.1 Review the Installation Drawings and Product Manual

Before installation, the project team confirms from the approved drawings and the manufacturer’s documentation: overall screen width and height, number of LED units, installation direction, unit numbering, mounting-bracket positions, support-frame dimensions, power-input locations, signal input and output locations, control-system layout, required clearance behind the screen, and the maintenance and replacement method. Different media facade products use different clips, connectors, brackets, power supplies and waterproofing methods, so the product manual takes priority over general advice. Do not drill, cut, weld or modify the LED screen frame unless the manufacturer and the project engineer approve the change.

2.2 Inspect the Mounting Surface

The mounting surface may be a concrete wall, steel structure, curtain-wall support, independent frame, stage truss or temporary structure. Inspect the surface for cracks, corrosion, loose materials, deformation, existing fixing points, water leakage, uneven areas and insufficient load-bearing capacity. Where that surface is a finished curtain wall on an occupied building, the sequence changes: retrofit onto an existing facade sets out the five surveys and the three mounting routes that follow from them. Brackets must connect to a verified structural element; decorative cladding, insulation panels and non-structural facade materials must not be treated as load-bearing without engineering approval.

2.3 Measure the Installation Area and Environment

Survey itemWhat to recordWhy it matters
DimensionsAvailable width and height, windows, doors, columns, beams, edge clearancePrevents alignment problems and clashes with building services
RoutesCable-entry points, power-supply distance, control-room locationSets cable lengths, voltage drop and signal distance
AccessPositions for lifts, cradles, scaffolds or rope accessDetermines installation method and future maintenance cost
EnvironmentWind exposure, rain, snow, temperature range, sunlight, dust, salt air, nearby trafficSets screen configuration, IP level, corrosion protection and brightness

3. Evaluate Structure and Wind Load

Wind load is one of the most important considerations for a media facade on a building. The structural assessment covers building height, project location, basic wind speed, screen dimensions, open-area ratio, screen orientation, mounting distance from the facade, bracket spacing, anchor type, steel-frame strength and connection strength. The open structure of an LED mesh screen lets air pass, but the screen still transfers loads to brackets, frames, anchors and the building. In the United States, ASCE/SEI 7 is the usual reference for minimum design loads; the structural engineer of record confirms the edition, wind parameters and calculations. The solid-area wind method for mesh screens is shown in the outdoor LED mesh selection guide.

Mounting methodTypical useKey engineering checks
Fixed facade-mountedPermanent screens on malls, offices, stadiums and media facadesBrackets, aluminum profiles or steel frame tied to structure
Steel frame-supportedLarge screens, uneven facades, screens set away from the wall, rear maintenance passageDead load, wind load, connection forces and maintenance loads
SuspendedConcerts, stages, trade shows and temporary eventsRated truss, ceiling, lifting points and rigging, all inspected
Curved or irregular surfaceCurved towers and free-form facadesMinimum bend radius, bend direction, support spacing, connector flexibility

A rigid screen unit must never be forced to follow a curve beyond the manufacturer’s specification.

4. Install the Support Frame and Mount the LED Units

4.1 Prepare Materials, Tools and Safety Equipment

CategoryTypical items
MaterialsSteel frames, aluminum profiles, brackets, bolts, nuts and washers, approved anchors, LED units, power and data cables, waterproof connectors, distribution boxes, cable trays or conduits, grounding conductors, seals
ToolsLaser level, spirit level, tape and laser distance meter, torque wrench, drill, socket tools, multimeter, insulation tester, cable-labeling tools, lifting equipment, access platforms
Safety equipmentHelmets, harnesses, fall-arrest equipment, gloves, safety shoes, insulated tools, barricades, warning signs, certified lifting equipment; in the United States see OSHA fall protection

4.2 Mark, Install and Align the Frame

  1. Mark reference points. Mark horizontal and vertical reference lines, bracket positions, anchor locations, the screen starting point, cable-entry points and maintenance zones. Check the first reference line carefully; a small error at the start becomes visible misalignment across the whole display.
  2. Install the main frame in sequence. Vertical supports, horizontal rails, mounting brackets, secondary members, connection plates, then screen fixing points, all tied to approved structural elements.
  3. Check level, plumb and spacing. Inspect horizontal level, vertical plumb, support spacing, frame flatness, distance from the facade and clearance around windows and equipment. A laser level is essential on large facades.
  4. Tighten and inspect connections. Verify fastener type, washers, thread engagement, torque to the drawing values, weld completion, corrosion protection and absence of movement.

4.3 Mount the LED Units

Install LED bars, modules or cabinets in their assigned numbers so the layout matches the installation, power, signal and control drawings and the maintenance records. Secure units with the product’s clips, bolts, quick-lock connectors, hooks or profiles and lock every connection before moving on. Check that all units share one plane, gaps are consistent, connectors are fully engaged, cables are not pinched and units are not twisted or over-tensioned. Inconsistent spacing produces visible lines and uneven images after commissioning. Reserve maintenance access — front access, rear access, walkways, cradles or removable sections — before installation, because a screen that cannot be reached safely is expensive to repair.

5. Low-Voltage Power Distribution

A high-rise media facade combines long DC runs, high switching currents, exposed metalwork and sensitive electronics. The robust topology distributes protected AC to local power-supply cabinets on each facade zone or floor; each cabinet converts AC to the fixture DC voltage and feeds short, independently protected DC branches. Keeping high-current DC distances short limits voltage drop and fault energy and makes isolation practical.

Distributed power topology with layered surge protectionService entrance with Type 1 or 1+2 SPD feeds the main switchboard, then zone or floor panels with Type 2 SPD, then local PSU cabinets with Type 2 or 3 SPD converting AC to DC, then fused DC branches to LED units. All metal frames, trays and cabinets bond to the equipotential bonding bar and earth. Lightning down conductor is kept separated from LED cables.Service entranceSPD Type 1 / 1+2Main switchboardfeeders, meteringZone / floor panelSPD Type 2Local PSU cabinetAC → DC · SPD 2/3Fused DC branchesto LED unitsAC distribution — long runsLow-voltage DC — short runsEquipotential bonding network → earth electrodeLPS down conductorkeep separation from LED cablesBond frames, cable trays, cabinets and exposed metal; coordinate SPD types from the origin to the load.Final SPD ratings follow the site risk assessment (IEC 62305) and local code.
Figure 2. Distributed power topology: AC is carried to local PSU cabinets near each facade zone, DC branches stay short and individually fused, and surge protective devices are coordinated from the service entrance to the load.

This section covers the checks the installation crew owns. The load study, cable sizing, inrush coordination and SPD selection belong to the electrical design package — the worked method for those is in High-Rise LED Media Facade Power Distribution and Lightning Protection. What follows is what must be verified on site before the first branch is energised.

5.1 Design Basis and Load Study

Before a cable is pulled, confirm on site that the fixture count, circuit allocation, cabinet positions and protection ratings match the approved drawings. Record every deviation: the load study and the breaker selection are both derived from the as-built count, not from the tender quantity.

5.2 Voltage-Drop Calculation

Voltage drop is calculated from measured loop resistance, not nominal cable length alone. For a two-conductor DC circuit, include the outgoing and return conductors, connectors, fuses and terminals, then calculate branch current from the actual load.

I = P ÷ V  |  ΔV = I × Rloop  |  Ploss = I × ΔV
ItemExampleEngineering action
Load power480 W at 24 V DCI = 480 ÷ 24 = 20 A
Loop resistance0.08 Ω including connectionsΔV = 20 × 0.08 = 1.6 V
Receiving voltage24 V − 1.6 V = 22.4 VVerify against the fixture minimum operating voltage
LossPloss = 20 × 1.6 = 32 WReview heat in cables and efficiency

If the calculated drop exceeds the fixture tolerance, shorten the branch, increase conductor cross-section, raise the distribution voltage where the equipment permits, split the load or move the power supply closer. Recalculate at the maximum design temperature because copper resistance rises with temperature. A dedicated analysis of uneven brightness is in preventing voltage drop and signal delay.

5.3 Inrush, Peak Current and Derating

Stagger cabinet energisation with programmable delays so that the inrush of every switch-mode supply does not land on one breaker. Derate conductors, terminals and enclosures for the real ambient temperature inside the facade cavity, which runs higher than the shaded air temperature the design may have assumed.

5.4 Cable Installation and Grounding

Terminate to the manufacturer’s wiring diagram, label every circuit at both ends, protect cables from sheet-metal edges, and bond frames, trays and cabinets to the equipotential bar before energising. NFPA 70 is the key reference where it applies; elsewhere follow the local electrical code.

6. Lightning Protection and Surge Coordination

Surge protection on a media facade is a layered system: Type 1 or 1+2 at the service entrance, Type 2 at zone or floor panels, Type 2 or 3 at the local PSU cabinets, with fused DC branches downstream. What the installation crew verifies is narrower than what the designer calculates: continuity of every bond, separation between LED cables and the down conductor, lead length at each SPD, and a status contact that can be read at handover.

The risk assessment under IEC 62305, the full SPD parameter table and the acceptance records are the electrical designer’s scope. They are set out in the dedicated guide to power distribution and lightning protection for high-rise media facades.

7. Signal and Control System

The control system of a media facade may include a media player or media server, video processor, sending card, receiving cards, pixel controllers, DMX splitters, network switches, data cables, control software and remote monitoring. LED mesh screens usually run on a video-processor and receiving-card topology; pixel-point and linear systems usually run on Art-Net or sACN to DMX512 or SPI controllers.

Media facade signal topologyMedia server sends Art-Net or sACN over Ethernet or fiber to a network switch, then to zone controllers. Each controller output feeds an opto-isolated DMX splitter, then daisy-chained fixtures with up to 32 unit loads per segment and a 120 ohm terminator at the end of each line. A video branch shows sending card to receiving cards for LED mesh screens.Media serverpixel mappingNetwork switchEthernet / fiberArt-Net/sACNZone controller AZone controller BOpto-isolatedDMX splitter120Ω120Ω≤ 32 unit loads per segmentSPI pixel strings — controller close to first pixelLED mesh video branchVideo processorscalingSending cardRX card 1RX card 2RX card 3optional loop-back for redundant signal path
Figure 3. Signal topology. Upper: media server → Art-Net/sACN → zone controllers → opto-isolated DMX splitters → daisy-chained fixtures with a 120 Ω terminator. Lower: video processor → sending card → receiving cards for an LED mesh screen, with an optional redundant loop.

Connect the system according to the approved signal topology and confirm input and output direction, receiving-card sequence, cable type, transmission distance, screen mapping, network configuration and backup signal path. An incorrectly connected data cable leaves part of the display blank or shows content in the wrong position. Route power and signal cables separately where the design requires; label, support and protect every cable from water, abrasion and moving parts. Protocol limits for DMX512 and SPI are compared in DMX512 vs. SPI control.

8. DMX/RDM Addressing and Commissioning

DMX512-A, standardized as ANSI E1.11, carries one-way control data; Remote Device Management (RDM, ANSI E1.20) adds bidirectional discovery, configuration and status reporting over the same line. Reliable DMX commissioning starts with a clear addressing plan, correct topology and disciplined verification. RDM reduces field time, but the final address map must still be locked and documented.

8.1 DMX Topology Rules

RulePracticeFailure if ignored
Daisy-chain topologyRun each DMX line fixture to fixture; avoid unmanaged star wiringReflections and intermittent response
Unit-load limitUp to 32 unit loads per segment, then an opto-isolated splitter or repeaterWeak signal at the far end
Termination120 Ω terminator at the last device of every lineFlicker and random color changes
CableShielded twisted pair rated for RS-485 data, shield continuity checkedNoise pickup on long facade runs
RDM compatibilityController, splitters and fixtures support the same RDM feature setDiscovery fails behind non-RDM splitters

8.2 Commissioning Workflow

  1. Label everything before power-on. Label every fixture and cable to match the universe schedule.
  2. Verify the physical layer. Check polarity, shield continuity, termination and protective earth.
  3. Discover with RDM. Discover devices, identify each fixture on the facade and assign the documented start address.
  4. Set operating parameters. Set mode, personality, start address and fail-safe (loss-of-signal) behavior.
  5. Test one universe at a time. Test full intensity, dimming curve, color, refresh behavior and loss-of-signal response.
  6. Export and record. Export the address map and keep photographs, test readings and spare-unit data.

Intermittent DMX response is usually caused by incorrect termination, poor shielding, ground potential differences, excessive passive splitting or an unsupported RDM command. Isolate the fault by testing from the controller toward the last known-good node.

9. Waterproofing, Drainage and Ventilation

Outdoor installation needs more than outdoor-rated LED units. Protect power connectors, data connectors, cable-entry points, junction boxes, distribution cabinets, the top and bottom screen edges and exposed connections according to the manufacturer’s instructions, and never block drainage or ventilation openings with sealant. Confirm the IP rating, defined by IEC 60529, separately for the screen front and rear, power supplies, control boxes, connectors and junction boxes. An IP rating is not a guarantee against every weather condition, poor installation or long-term water accumulation. Before commissioning, verify that water cannot collect behind the screen, drainage paths are open, drip loops keep water away from connectors and power supplies have enough space to dissipate heat.

10. Testing and Electrical Safety

Commissioning is a controlled electrical activity, not a visual-only lighting check. Use an approved method statement, permit-to-work, lockout/tagout, competent personnel, calibrated instruments, barriers and an emergency plan. Treat every circuit as live until it is isolated, proved dead and secured against re-energization.

Staged commissioning and test sequenceSix stages: visual and mechanical inspection; isolate electronics and run insulation tests; reconnect, check polarity, earth continuity and protective devices; energize one branch at a time with current monitoring; DMX RDM addressing and scene tests; full-system burn-in and acceptance.1 INSPECTLabels, seals,torque marks,earth, damage2 INSULATIONIsolate drivers,SPDs, LEDs;test & record3 RECONNECTDischarge, polarity,earth continuity,RCD / breakers4 ENERGIZEOne branchat a time; V atsource & far end5 CONTROLRDM addressing,mapping, scenes,signal loss6 BURN-INContinuous run,thermal check,restart testNever megger through connected electronics · never bypass protection to force a start
Figure 4. Staged commissioning sequence: inspection, insulation testing with electronics isolated, reconnection checks, branch-by-branch energizing, control commissioning and full-system burn-in.

10.1 Pre-Power and Insulation Tests

  • Inspect labels, enclosure seals, cable glands, torque marks, polarity, protective earth, bonding and physical damage.
  • Isolate sensitive drivers, controllers, SPDs and LED modules before insulation resistance testing unless their manufacturers permit the test voltage and method.
  • Test conductor-to-earth and conductor-to-conductor insulation on isolated circuits at the voltage specified by the design and the equipment manufacturers; record test voltage, duration, temperature, circuit identity and result.
  • Discharge tested circuits, reconnect equipment, verify polarity and perform earth continuity and protective-device checks.

10.2 Staged Energizing and Display Tests

  • Energize one branch at a time with current monitoring; confirm voltage at the source and at the farthest load under normal and peak scenes.
  • Inspect each section for blank areas, flicker, dead pixels, incorrect colors, uneven brightness, signal loss, abnormal noise, overheating and loose connections.
  • Configure resolution, module layout, brightness, refresh rate, grayscale, color temperature, orientation, input source and content aspect ratio. Set brightness to ambient light; excessive brightness wastes energy and causes glare.
  • Verify SPD indicators, alarm contacts, RCD or equivalent protection, emergency isolation, control fallback, thermal behavior and restart after interruption.
  • Run the complete system continuously for the period specified by the project or manufacturer, monitoring temperature, power stability, signal, uniformity, color consistency, controller performance and unexpected shutdowns.

Do not

Never megger through connected electronic equipment, never bypass protective devices to force a start, and never work on exposed conductors during a live scene test. Where the local electrical code or the equipment manufacturer is more restrictive, follow the stricter rule.

11. Acceptance Inspection and Handover

Inspection areaAcceptance criteria
MechanicalScreen securely fixed, support structure stable, fasteners tight, surface aligned, spacing consistent, no deformed frames, maintenance access available
ElectricalCircuits labeled, grounding complete, protective devices operate, cables secured, connectors protected, cabinets accessible, emergency shutoff identified
DisplayFull-screen image, brightness uniformity, color consistency, refresh performance, signal stability, content playback, remote control and monitoring alarms
ControlFinal universe and address map locked, RDM discovery report matches the fixture schedule, fail-safe behavior verified

Handover Documentation Package

  • As-built installation drawings and screen-unit numbering
  • Single-line diagrams, load schedules, voltage-drop calculations and protection settings
  • SPD certificates, bonding and earth test results, insulation records and torque records
  • Signal-wiring diagram, universe schedule, fixture schedule, RDM discovery report and firmware record
  • Control-system configuration, scene files and thermal observations
  • Testing records, photographs, commissioning checklist and maintenance access plan
  • Warranty documents, maintenance instructions and replacement-parts information

12. Maintenance and Common Installation Mistakes

Regular maintenance catches structural, electrical and display problems before they cause downtime. Inspection frequency should reflect the screen location, weather exposure, building height and local requirements.

Maintenance taskWhat to check
Mounting structureBrackets, bolts, welds, anchors, corrosion, frame deformation, screen movement, excessive vibration
Cables and connectionsLoose connectors, cracked seals, cable aging, water ingress, damaged insulation, corrosion
Surge protectionStatus indicators and bonding at every scheduled inspection, after any known surge or lightning event and after any fault
CleaningOnly the method in the product manual; high water pressure or unsuitable chemicals damage LEDs, coatings and seals
Unit replacementSwitch off the circuit, confirm the unit number, fit a compatible part, check connections, test, recalibrate if needed, record the work
Common mistakeConsequence
Installing on a non-structural surfaceDecorative cladding cannot carry the display and its frame
Ignoring wind loadA lightweight screen still transfers large forces to brackets and anchors
Skipping alignment checksVisible gaps and uneven screen lines
No maintenance accessRepairs need expensive lifting equipment or partial dismantling
Poor cable managementSignal faults, water damage and slow troubleshooting
Insufficient waterproofingOutdoor-rated components fail at unprotected connectors and entries
Powering on before inspectionDamaged components and unnecessary electrical risk
Missing DMX termination or overloaded segmentsFlicker and intermittent response across whole universes
Unapproved modificationsDrilling, cutting or welding affects structure, performance and warranty
Testing only a few unitsSystem-level faults appear after handover

13. Contractor Checklist

Before installationDuring installationAfter installation
Drawings approved; manual reviewedReference lines markedElectrical safety inspection completed
Site dimensions confirmedSupport frame installed and alignedInsulation, continuity and SPD checks recorded
Mounting surface inspectedFasteners tightened to torqueScreen units tested branch by branch
Wind load evaluated; fixing points verifiedUnits installed by number; spacing checkedDMX/RDM address map locked and exported
Load study and voltage drop calculatedPower and signal cables connected and labeledFull-system burn-in completed
Lightning risk assessment and SPD planGrounding and bonding completedBrightness and color checked
Cable routes and maintenance access plannedWaterproofing, drainage and ventilation checkedHandover documents and maintenance schedule delivered

14. Frequently Asked Questions

Should every LED branch on a media facade have its own fuse?

Usually each DC branch or defined group should have protection matched to the conductor, driver, connector and DC fault rating. Confirm selectivity and the manufacturer’s maximum fuse size, because one large upstream fuse may not protect small branch conductors.

Can a Type 2 SPD replace a Type 1 SPD at the main entrance?

No, not where the installation can carry partial lightning current or where the IEC 62305 risk assessment requires Type 1 capability. The entrance device and downstream SPDs must be selected and coordinated for the building’s lightning current path and earthing arrangement.

Why does a media facade look uneven at full brightness?

Common causes are voltage drop, unequal branch lengths, thermal derating, connector resistance, calibration differences and overloaded power supplies. Measure source and load voltage while the full-brightness scene runs, then inspect the highest-resistance connections.

Is an insulation resistance test always safe for an LED system?

No. A megohmmeter can damage LED drivers, SPDs, controllers and modules. Isolate or disconnect sensitive equipment and use the test method and voltage approved for the installed system.

How many fixtures can one DMX line support?

A DMX512 segment supports up to 32 unit loads before an opto-isolated splitter or repeater is needed, and one universe carries 512 channels — about 170 RGB fixtures at 3 channels each. Long facade runs should use splitters, shielded twisted-pair cable and a 120 Ω terminator at the end of every line.

What causes intermittent DMX response during commissioning?

Intermittent DMX response is usually caused by missing or wrong termination, poor shielding, ground potential differences, excessive passive splitting or an RDM command that a splitter or fixture does not support. Test from the controller toward the last known-good node to isolate the fault.

15. Conclusion

A media facade installation is an engineering project, not an assembly task. Contractors who confirm the facade condition, mounting points, wind load, screen layout, electrical capacity, cable routes and maintenance access before construction avoid the most expensive failures. During construction, the support frame must be fixed and aligned before units are mounted; power runs as protected AC to local PSU cabinets with short fused DC branches; surge protection is coordinated from the service entrance to the load; and the signal network follows DMX rules of 32 unit loads per segment and 120 Ω termination. Commissioning proceeds in stages — insulation tests with electronics isolated, branch-by-branch energizing, RDM addressing and full burn-in — and ends with a complete handover record.

References

Standards vary by country, state, city and project type. These references support planning; they do not replace project-specific engineering documents or local authority requirements. Always use the currently adopted edition.

Need a commissioning-ready facade package?

Send the elevation, feeder schedule, fixture voltage, branch lengths and lightning protection concept. MEKALEO engineers review topology, voltage drop, protection coordination and DMX/RDM commissioning.

Request an Engineering Review →

Updated: October 29, 2026 · MEKALEO Engineering Team
